Development

Development of our modular bridge solution

How they began..

Card image.

2012

Modular Bridge Mark 1: Highways Agency, A453 Widening reducing abutment construction from four weeks to three days, with a 25% labour reduction per bridge, 25% programme reduction per bridge and a six-month overall programme saving

Card image.

2014

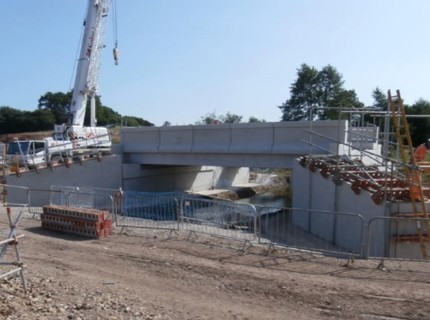

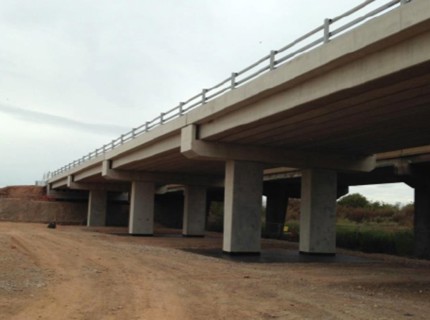

Modular Bridge Mark 2: Stafford Alliance, Network Rail, Stafford Area Improvement providing a bridge in a week with a 40% labour reduction per bridge and 40% programme reduction per bridge

Card image.

2015

Expanded trialled our modular abutment

Card image.

2016

Modular Bridge Mark 3: East West Rail, Network Rail delivering a bridge in five days with 40% labour reduction per bridge, 50% programme reduction per bridge and further developed product set

Card image.

2017

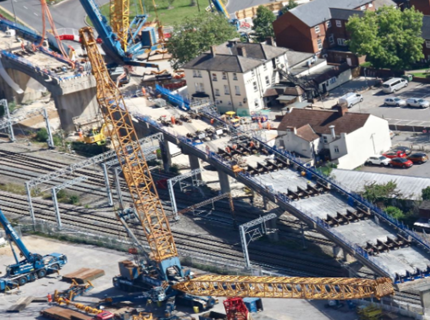

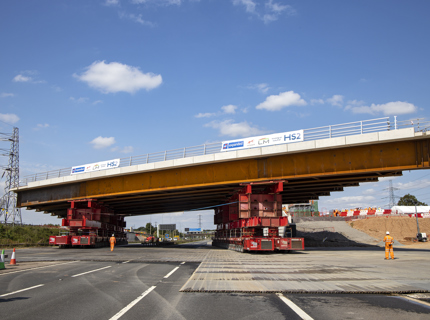

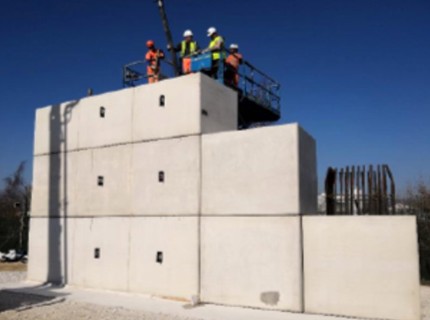

Modular Bridge Mark 4: HS2 Enabling works, delivering a bridge in two days with a 50% labour reduction per bridge, 70% programme reduction per bridge and further developed product set

Card image.

2019

Flexible abutment trial

Card image.

2021

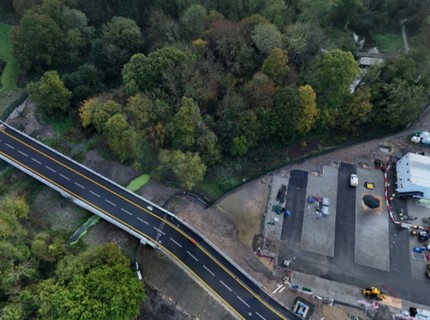

Shepperton Studios South, delivery of a precast bridge over the River Ash. We also managed the flood rick activity permit approval process with the EA.

Card image.

2023

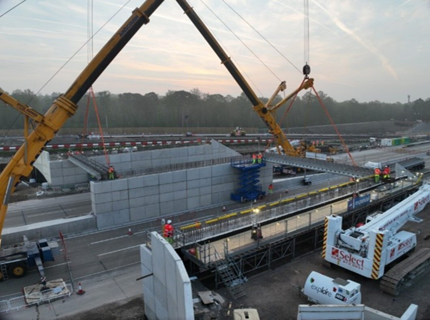

Modular Bridge Mark 5: M25 J10 Improvement, Balfour Beatty, installing bridges during scheduled weekend daytime closures, regularly reopening the road up to eight hours early.

Card image.

2025 onwards

Next generation of modular bridges, including a product-led approach to design using valuable, reusable digital assets, pre-engineered components selected based on engineering-driven decisions, automation of routine processes – design, manufacture and construct, super-fast generation of design outputs and production information, design informed by cost, rather than just costing design, confidence in price and programme and enablement of effective lifecycle quality management
